what is the critical path of this project?

You are the project manager of the GHQ Project. You have to prioritize activities for the effective

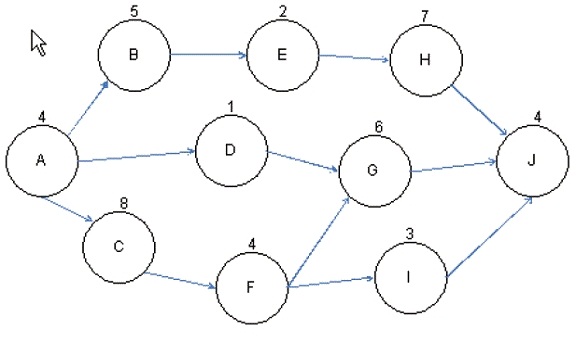

management of project. For this, you have created a network diagram to schedule a set of project
activities as shown in the figure:

Based on this figure, what is the critical path of this project?

PrepAway - Latest Free Exam Questions & Answers

A.
ABEHJ

B.
ACFIJ

C.
ADGJ

D.
ACFGJ

Explanation:
The activity nodes of path ACFGJ equals 26 days and is the longest path to completion – it is the
critical path.
ACFGJ= A(4)+C(8)+F(4)+G(6)+J(4)=26
What is a critical path?

A critical path is the sequence of project activities, which add up to the longest overall duration.
This determines the shortest time possible to complete the project. Any delay of an activity on the
critical path directly impacts the planned project completion date (i.e. there is no float on the critical
path). A project can have several, parallel, near critical paths. An additional parallel path through
the network with the total durations shorter than the critical path is called a sub-critical or non-critical path. These results allow managers to prioritize activities for the effective management of
project completion, and to shorten the planned critical path of a project by pruning critical path
activities, by “fast tracking” (i.e., performing more activities in parallel), and/or by “crashing the
critical path” (i.e., shortening the durations of critical path activities by adding resources).
Answer option A is incorrect. ABEHJ takes only 22 days to complete; it is not the critical path.
ABEHJ=A(4)+B(5)+E(2)+H(7)+J(4)=22
Answer option C is incorrect. ADGJ takes only 15 days to complete; it is not the critical path.
ADGJ=A(4)+D(1)+G(6)+J(4)=15
Answer option B is incorrect. ACFIJ takes only 23 days to complete; it is not the critical path.
ACFIJ=A(4)+C(8)+F(4)+I(3)+J(4)=23
